Juba – Torit National Fiber Backbone (Phase I)

.

In line with its National Fiber Infrastructure License issued by the National Communications Authority, Nile Cable and Towers Limited (NCT South Sudan) successfully delivered its first large-scale fiber backbone project between 2022 and 2023, establishing a high-capacity digital corridor from Juba to Torit.

This landmark deployment marked Phase I of NCT’s broader national digital backbone strategy, designed to interconnect major cities, enable reliable broadband access, and position South Sudan as a regional connectivity hub.

whatsapp image 2026 02 12 at 7.22.51 pm wefascdwxw

Project Overview

  • Route: Juba – Torit
  • Total Length: 135 km
    • 128 km Underground deployment
    • ~7 km Aerial deployment
  • Additional Works: 4 km Underground Metro Fiber Expansion within Torit
  • Network Type: Carrier-grade Backbone & Metro Access Network
  • Operational Readiness: Fiber completed and ready for service since September 2024
  • Ownership: Fully owned and operated by NCT South Sudan

NEWS & UPDATES

Click below for current news and updates!

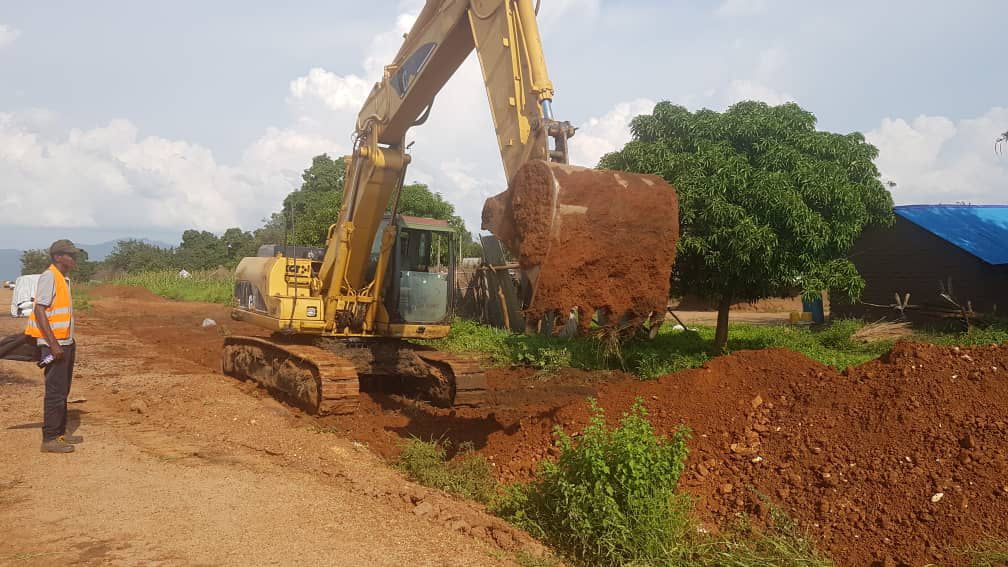

whatsapp image 2026 02 13 at 8.10.29 pm
whatsapp image 2026 02 13 at 8.10.18 pm
whatsapp image 2026 02 13 at 8.10.49 pm
whatsapp image 2026 02 13 at 8.10.09 pm

Technical Scope & Infrastructure Design

whatsapp image 2026 02 12 at 7.22.51 pm fewadxsaz

The project was engineered as a future-ready, scalable backbone infrastructure, ensuring long-term sustainability and expansion capacity.

Underground Deployment

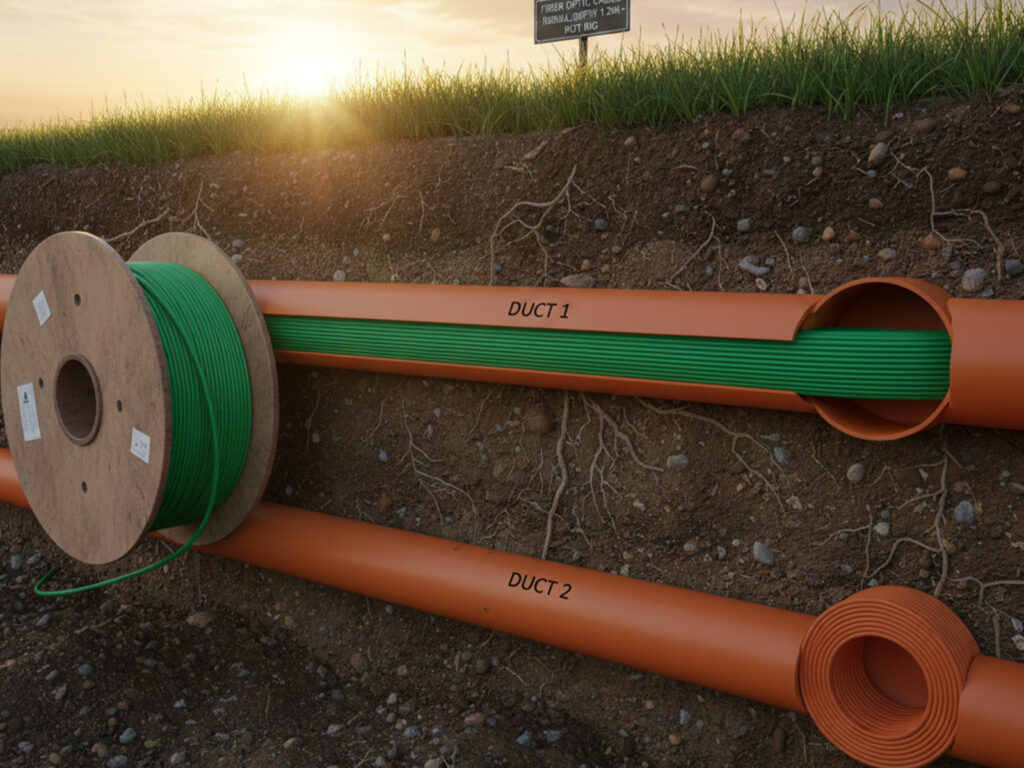

  • Installation of dual HDPE duct system along the entire backbone route:
    • Duct 1: Installed with 72-core single-mode fiber optic cable
    • Duct 2: Reserved empty duct for future fiber expansion and redundancy
  • Standard burial depth of 1.2 meters, ensuring:
    • Mechanical protection
    • Long-term durability
    • Reduced risk of accidental damage
  • Use of advanced fiber blowing techniques for cable installation to:
    • Minimize cable stress
    • Improve installation efficiency
    • Enhance long-term performance

Aerial Deployment

Approximately 7 km of aerial fiber was deployed in areas where underground installation was not feasible. This ensured continuity of the backbone while maintaining structural integrity and performance standards.

gemini generated image rle85irle85irle8

Civil Works & Machinery Deployment

Given the terrain challenges and the strategic importance of the corridor, NCT mobilized a full fleet of heavy-duty machinery, including:

  • Heavy trenching machines
  • Excavators
  • Backhoes
  • Motor graders
  • Light trenchers
  • Support and compaction equipment

All civil works were executed under strict engineering supervision, maintaining alignment accuracy, trench depth compliance, and environmental considerations.

gemini generated image wxfptxwxfptxwxfp copy

River & Road Crossings

Each crossing incorporated additional protection mechanisms, including reinforced ducting and structural safeguards to ensure resilience against erosion, traffic loads, and environmental stress.

erwqdsa

Special attention was given to crossings of:

cdsac

Regulatory Compliance & Right of Way (ROW)

For the execution of this strategic infrastructure project, NCT:
Secured all necessary licenses and regulatory approvals
Obtained official Right of Way (ROW) permissions
Coordinated with local authorities and stakeholders along the entire route
This ensured smooth execution and long-term legal protection of the infrastructure corridor.

Torit Metro Expansion

In addition to the backbone deployment, NCT expanded the Torit Metro Network by approximately 4 km (underground), enabling:
Direct connection of enterprise clients
Access for government institutions
Capacity for ISPs and telecom operators
Scalable broadband services within Torit town
This metro extension serves as the foundation for local digital transformation and enterprise connectivity.

Commercialization & Service Readiness

The network has been fully completed, tested, and is operational since September 2024. NCT offers the infrastructure in both:
Dark Fiber Leasing – For operators requiring full control over their transmission equipment
Lit Fiber / Managed Bandwidth Services – For clients seeking ready-to-use capacity
NCT has already commenced leasing capacity to Digitel South Sudan, marking the first commercial utilization of this national backbone segment.

wdaxqwfd

Strategic Impact

This Juba–Torit backbone represents:

  • The first major privately developed national fiber corridor under NCT’s infrastructure strategy
  • A critical step toward nationwide fiber interconnection
  • A backbone capable of supporting:
    • Mobile network operators
    • ISPs
    • Government networks
    • Financial institutions
    • Enterprise and data center connectivity

      By deploying dual-duct infrastructure with reserved expansion capacity, NCT ensured that this project is not just a connectivity solution for today, but a scalable digital highway for decades to come.
